Project under implementation by Water Supply Resource Management Cell, MMRDA

Ongoing Projects

  • 403 MLD Surya Regional Water Supply Scheme – Implemented by MMRDA
  • Deharji Dam Project – Funded by MMRDA & implemented by KIDC
  • Kalu Dam Project – Funded by MMRDA & implemented by KIDC

WSRMC Chart English

Surya Regional Water Supply Scheme

Brief Description

The 403 MLD Surya Regional Water Supply Scheme is MMRDA’s pioneering project designed to develop and implement a bulk water supply system at the regional level. The Scheme was formulated by MMRDA to supply bulk drinking water to the Western Sub-Region of MMR i.e. Mira-Bhayander Municipal Corporation (MBMC), Vasai Virar City Municipal Corporation (VVCMC), and enroute 44 villages in Palghar District.

Location of Project

  • Source of Raw Water: Surya Dam, Village: Dhamani, Taluka: Jawhar
  • Intake Structure: Village: Kawadas, Taluka: Vikramgad, Dist: Palghar
  • Water Treatment Plant: Village: Veti, Taluka: Dahanu, Dist: Palghar
  • Other Infrastructure: Spans from WTP to Vasai Virar & Mira Bhayandar

Project Beneficiaries

Sr. No. Beneficiaries Current Population
(As per information received from each corporation)
Present Demand (MLD) Current Supply (MLD) Water Supply from Surya Project (MLD) Deficit (MLD)
a. Vasai Virar City Municipal Corporation (VVCMC) & enroute 44 villages 25 Lakhs 422 400 180 (Water Supply commenced) 22 (5.2%)
b. Mira Bhayander Municipal Corporation (MBMC) 15 Lakhs 240 195 218 55 (22.9%)
c. 44 villages in Palghar District 2.2 Lakhs (Year 2051) 15 - 15 -
TOTAL 403 (MLD)

Contract Details

  • Project Contract Cost: 1329.01 Cr. (Includes 08 years of Operation & Maintenance of scheme)
  • Project Contractor: M/s. L&T Construction
  • Project Consultant: M/s. STC Consortium
  • Date of Award of Contract: 04.08.2017
  • Project Duration: 34 months
  • Revised Date of Completion: 31.12.2025

1. Project Planning

  • Evaluate water supply needs based on population growth & demand trends in regional area of MMR.
  • Conduct technical, financial, environmental, and social assessments.
  • Budget planning, funding arrangements, and resource mobilization.
  • Develop preliminary and detailed designs in coordination with appointed consultants.

2. Project Implementation

  • Secure necessary statutory permissions from concerned authorities.
  • Issue bids, evaluate proposals, and award contracts following government procurement norms.
  • Ensure adherence to legal, environmental, and safety standards during project execution.

3. Project Construction

  • Oversee construction activities to ensure quality control and adherence to timelines.
  • Resolve on-site challenges related to engineering, materials, or logistics.
  • Conduct regular site visits & testing to maintain construction standards.

4. Project Monitoring

  • Use digital tools and periodic reporting to track project milestones and budget utilization.
  • Identify risks such as delays, cost overruns, or technical failures and propose mitigation strategies.
  • Maintain transparency through regular public disclosures and updates.

5. Operation & Maintenance (O&M)

  • Ensure continuous and efficient operation of water supply systems.
  • Plan and implement preventive and corrective maintenance for infrastructure and equipment.
  • Develop mechanisms for billing, metering, and cost recovery.
  • Promote user awareness for water conservation.
  • Implement measures to reduce water losses, promote recycling/reuse, and ensure long-term resource sustainability.

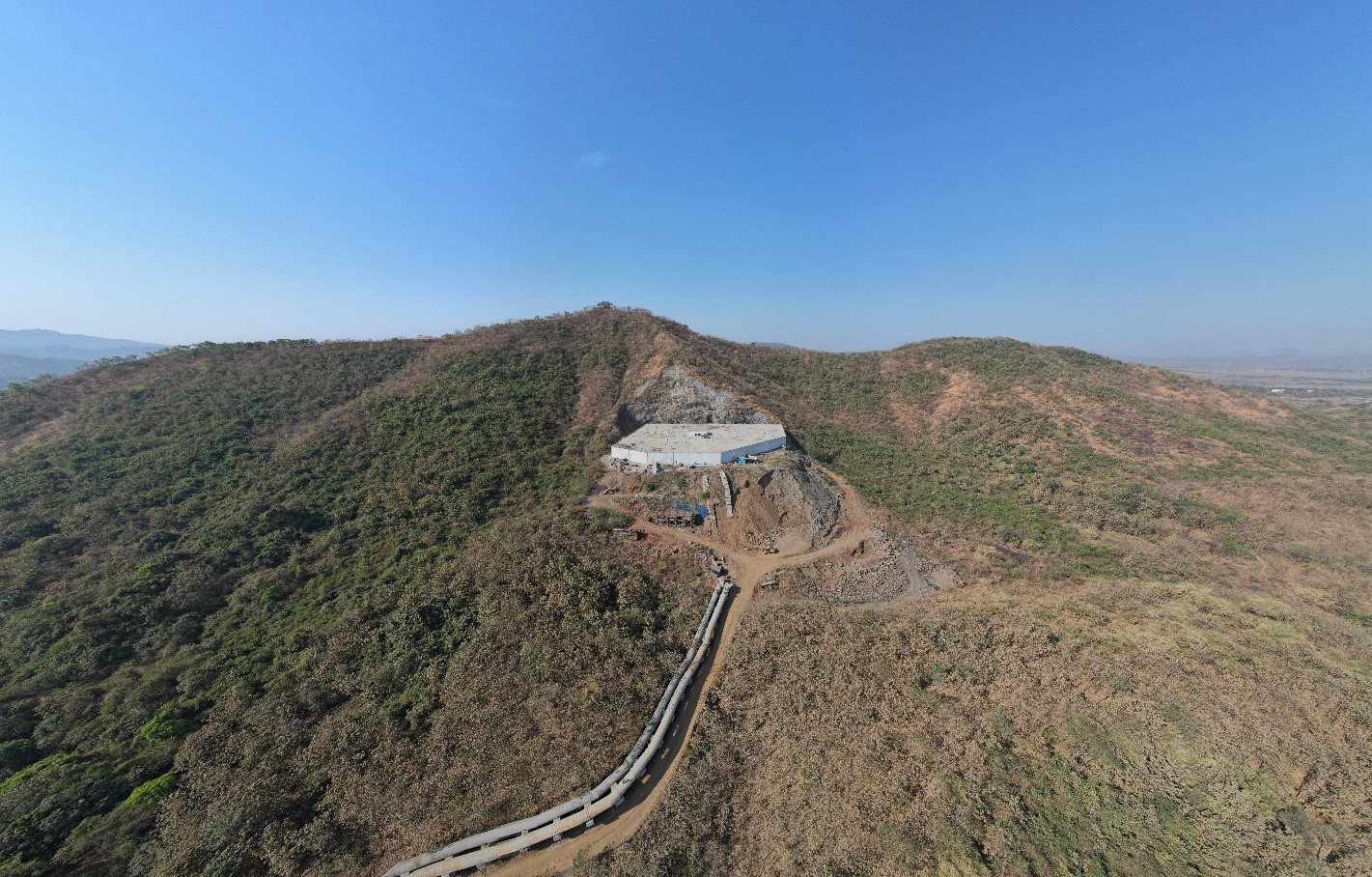

  • Construction of Intake Structure at Kawadas Weir of capacity 432 MLD
  • Construction of WTP of 418 MLD capacity at Suryanagar
  • Construction of BPT of 1.08 ML at Suryanagar
  • Raw & Clear Water Pumping Main: Dia = 2235 mm, Length = 2.3 kms
  • Gravity Main from BPT to Kashidkopar Junction: Dia = 2235 mm, Length = 55.5 km
  • Gravity main from Kashidkopar MBR to Chene MBR: Dia = 1829 mm, Length = 22.8 km
  • Medhwankhind Tunnel (Length = 1.7 km, Dia = 2.85 m)
  • Tungareshwar WLS Tunnel (Length = 4.6 km, Dia = 2.85 m)
  • Kaman Creek Micro Tunnel (Length = 300 m, Dia = 2 m)
  • Vasai Creek Micro Tunnel (Length = 720 m, Dia = 2 m)
  • MBR at Kashidkopar for VVCMC - 38 ML
  • MBR at Chene for MBMC - 45 ML

Considering the rising water demands and water scarcity crisis in Vasai Virar region, MMRDA has partially commissioned the scheme under Phase–I with regular water supply to Vasai-Virar City Municipal Corporation from 15.11.2023. The scheme was inaugurated by Hon. Prime Minister, Shri Narendra Modi on 12.01.2024. The treated bulk water in the range of 160-170 MLD is being supplied to VVCMC from Kashidkopar MBR. The project caters drinking water demand of around 14 lakh population in Vasai Virar Region under Phase -I.

The Scheme will supply 218 MLD of treated bulk water to MBMC and enroute 44 villages in Palghar district under Phase –II. The execution works of Phase-II are currently in progress. The works are planned for completion by end of Dec 2025. This water shall cater the demand of approx. 16 lakh population in Mira Bhainder city. The commissioning of Phase –II is dependent on availability of 132 kV power supply from MSETCL.

Project Work Components and Progress
Sr. No. Work Component Scope Status of Work Progress (%)
1 Intake Structure at Kawadas 432 MLD Completed and commissioned in Phase-I 99%

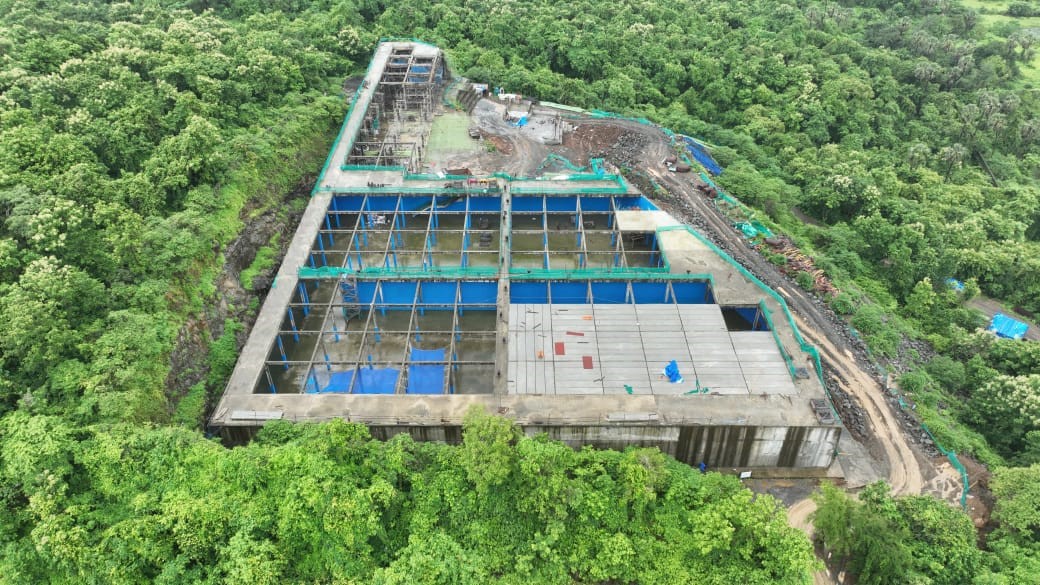

2 Water Treatment Plant 418 MLD Completed 97%
3 Break Pressure Tank (In WTP Premises) 1.035 ML Completed 100%
4 Pipe Laying Works Length & Diameter
A. Intake to WTP 2.35 km, 2.235 m φ Completed 100%
B. BPT to Kashidkopar Junction 55.52 km, 2.235 m φ Completed 100%
C Kashidkopar to Chenne 22.84 km, 1.829 m φ In progress 87%

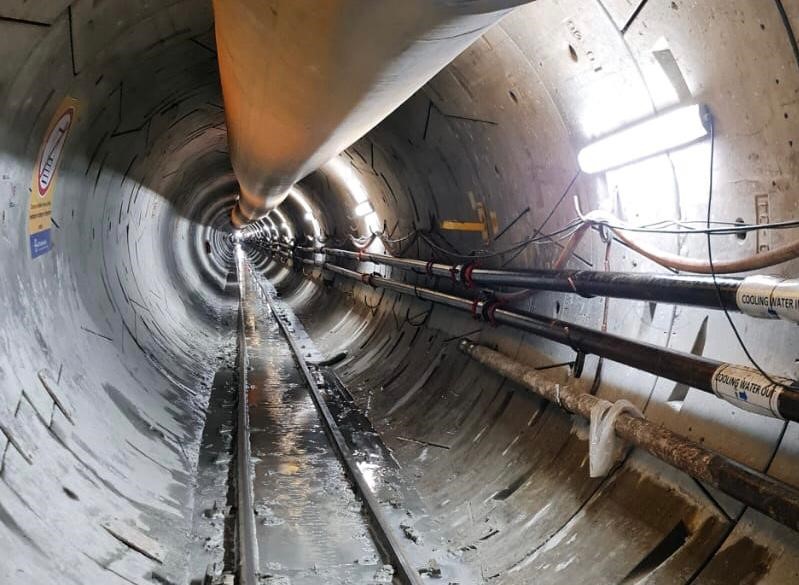

5 Underground Tunnels - 4 Nos. Length & Diameter
A. Mendwandkhind Tunnel (For crossing of NH-08) 1.7 km, 2.85 m φ Completed 100%
B. Tungareshwar WLS Tunnel (For crossing of TWLS) 4.45 km, 2.85 m φ Completed. Testing of tunnel by Oct 2025 98%
C. Vasai Creek Tunnel 0.9 km, 2.0 m φ Work in progress. Completion by Nov 2025 25%
D. Kaman Creek Tunnel 0.250 km, 2.0 m φ Boring of tunnel completed. Completion by Nov 2025 82%
6 Master Balancing Reservoirs – 2 Nos. Capacity
A. Kashidkopar MBR (For VVCMC) 38 ML Completed 100%
B Chene MBR (For MBMC) 45 ML Work in progress. Completion by Nov 2025* 70%

GoM orders for Diversion & Re-diversion of Forest land in favour of MMRDA for Surya Water supply Project :

Notice Data
S. No. Description Details
1 Diversion (214.63 KB)
2 Rediversion (192.92 KB)
3 Public Notice for Vasai Creek and Kaman River (905.79 KB)

CRZ Approval for Vasai Creek & Kaman River :

Notice Data
S. No. Description Details
1 Vasai Creek (362.79 KB)
2 Kaman River (390.46 KB)

Private Land Notifications :

Notice Data
S. No. Description Details
1 Vasai (1.44 MB)
2 Mendhavan (994.81 KB)
3 Varai (985.24 KB)
